Construction Updates

We’re proud to share that the perfect place to build your dream home is taking shape before your eyes.

Under Construction:

Release Titles Completed Jan 2022 Estimated Settlement Due Feb 2022

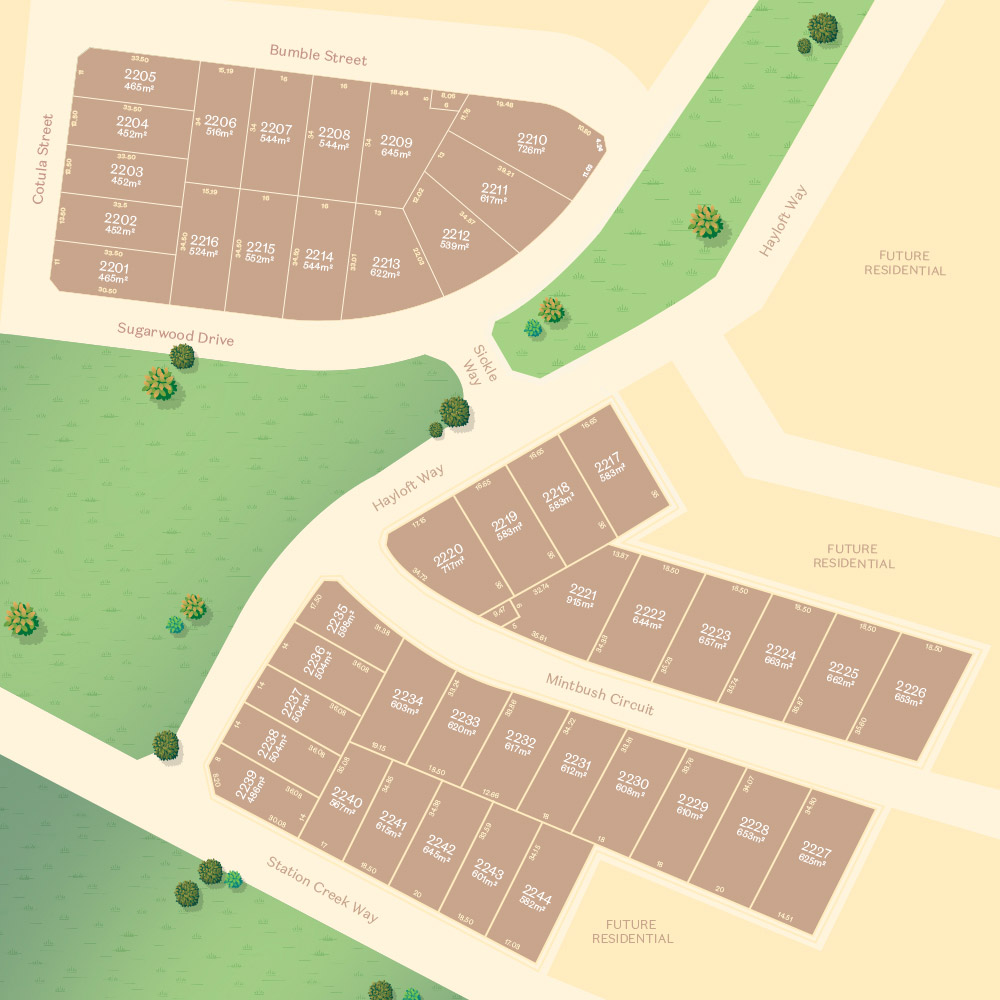

Stage 22

Works %
Registration %

WorksCompleted


Site EstablishmentFeb-21


Bulk EarthworksMar-21


Sewer ReticulationMar-21


DrainageApr-21


Water ReticulationMay-21


Subgrade Placement WorksMay-21


Electrical and NBNJun-21


Footpaths/ Ashpalt/ Line MarkingAug-21


Practical CompletionOct-21



Registration50%


Statement of ComplianceDec-21


Lodge Plan of SubdivisionDec-21



Release Estimated Titles Due Mar 2022 Estimated Settlement Due Apr 2022

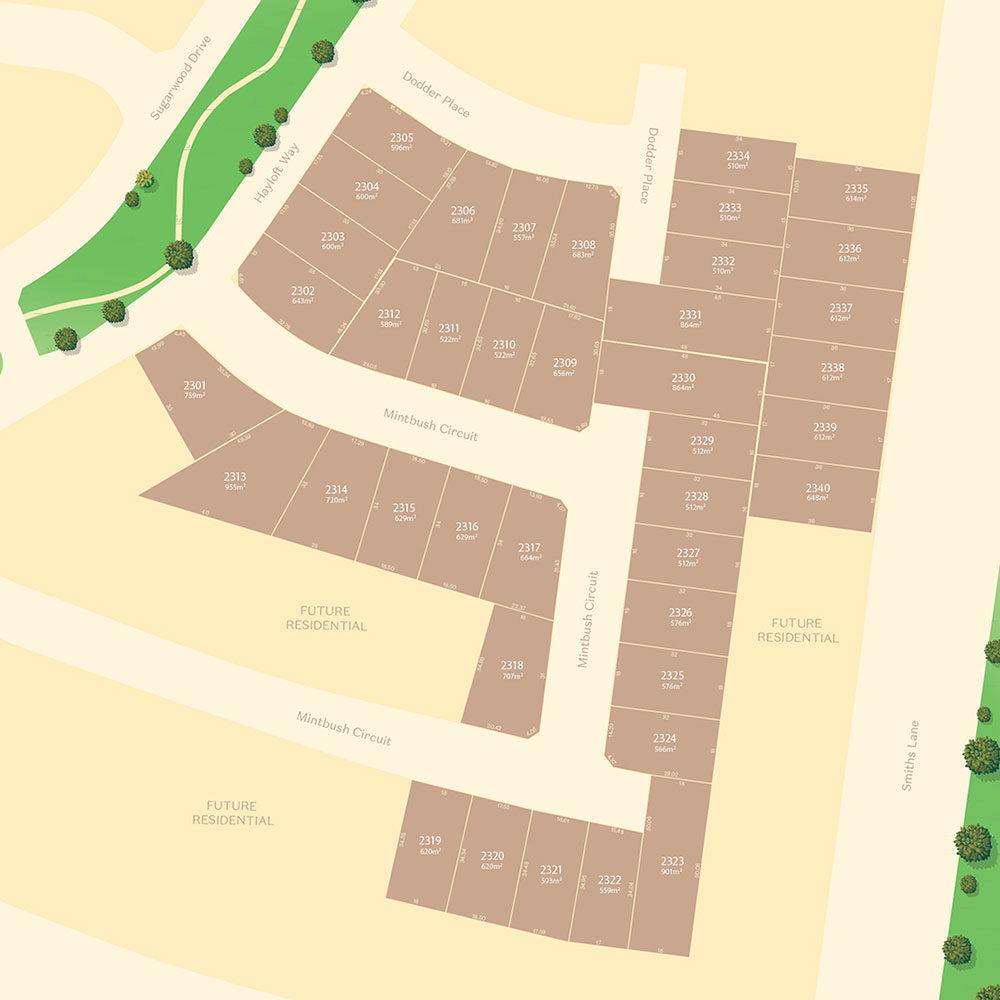

Stage 23

Works %
Registration %

Works60%


Site EstablishmentJul-21


Bulk EarthworksAug-21


Sewer ReticulationAug-21


DrainageSep-21


Water ReticulationOct-21


Subgrade Placement WorksIn progress


Electrical and NBNIn progress


Footpaths/ Ashpalt/ Line Marking


Practical Completion



Registration


Statement of Compliance


Lodge Plan of Subdivision



Release Estimated Titles Due Jun 2022 Estimated Settlement Due Jul 2022

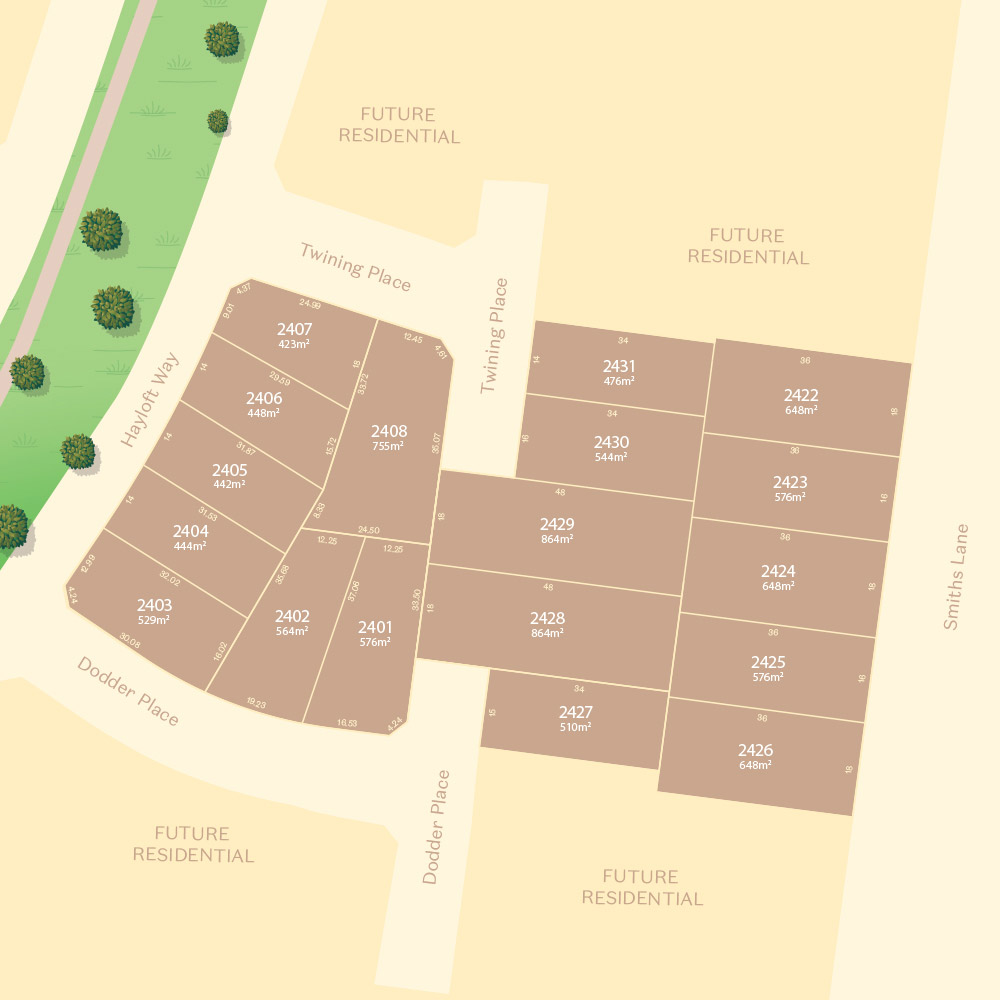

Stage 24a

Works %
Registration %

Works35%


Site EstablishmentSep-21


Bulk EarthworksOct-21


Sewer ReticulationOct-21


Drainage


Water Reticulation


Subgrade Placement Works


Electrical and NBN


Footpaths/ Ashpalt/ Line Marking


Practical Completion



Registration


Statement of Compliance


Lodge Plan of Subdivision



Coming Soon:

Release Estimated Titles Due Sep 22 Estimated Settlement Due Oct 22

Stage 24b

Completed:

Release Estimated Titles Due Mar 2021 Estimated Settlement Due Apr 2021

Stage 18b
